Project estimation plays a crucial role in project management, directly impacting budgets, timelines, and resource allocation. One of the most effective techniques for achieving more accurate project estimates is Three-Point Estimation. This method helps project managers reduce uncertainty by considering multiple scenarios instead of relying on a single-point estimate.
Three-Point Estimation is a project estimation technique that considers three different scenarios to provide a more realistic estimate:
By incorporating these three estimates, project managers can make better-informed decisions and improve project accuracy.
There are two primary methods for calculating three-point estimation:
This method gives equal weight to all three estimates:
This method gives more weight to the most likely estimate:
Three-Point Estimation is a technique used in project management to improve the accuracy of time and cost estimates by considering uncertainty and risk.
Before applying the Three-Point Estimation method, it is essential to break down the project into smaller, manageable tasks. This process is often done using a Work Breakdown Structure (WBS).
By identifying all project tasks upfront, you create a strong foundation for accurate estimation.
Once tasks are identified, the next step is to collaborate with stakeholders and team members to estimate the time or cost required for each task. This step is crucial for determining the Optimistic (O), Most Likely (M), and Pessimistic (P) values for each task.
Each expert's input helps refine the estimates and ensures they are grounded in practical experience.
After gathering the three values (O, M, P) for each task, you can apply one of the following formulas to compute the final estimate:
E=(O+M+P)3E = \frac{(O + M + P)}{3}E=3(O+M+P)
This method provides a simple average of the three estimates.
It is useful for quick estimations but may not account for uncertainties as effectively as the PERT method.
E=(O+4M+P)6E = \frac{(O + 4M + P)}{6}E=6(O+4M+P)
The PERT formula assigns more weight to the Most Likely (M) estimate, making it more accurate.
It is recommended for projects where uncertainty and risk analysis are critical.
Assume a task has the following estimates:
E=(5+10+20)3=11.67 daysE = \frac{(5 + 10 + 20)}{3} = 11.67 \text{ days}E=3(5+10+20)=11.67 days
E=(5+4(10)+20)6=10.83 daysE = \frac{(5 + 4(10) + 20)}{6} = 10.83 \text{ days}E=6(5+4(10)+20)=10.83 days
The PERT estimate (10.83 days) is slightly lower than the Triangular Distribution estimate (11.67 days), as it considers the most likely scenario more heavily.
The final step is to evaluate the estimates to determine project feasibility and improve risk management.
By analyzing the results, project managers can make informed decisions, adjust schedules, and optimize resource allocation for better project planning. Three-Point Estimation is an effective technique for reducing uncertainty in project estimates.
By following these four steps—identifying project tasks, gathering expert opinions, applying the formula, and analyzing the results—teams can achieve more accurate project timelines and cost predictions, leading to better project execution. 🚀
DhiWise Requirement Builder streamlines project estimation by automating and structuring the requirement-gathering process. Traditional project estimation involves extensive manual effort, often leading to inconsistencies and scope misalignment. DhiWise simplifies this by ensuring clarity, accuracy, and efficiency in forecasting effort, time, and costs.

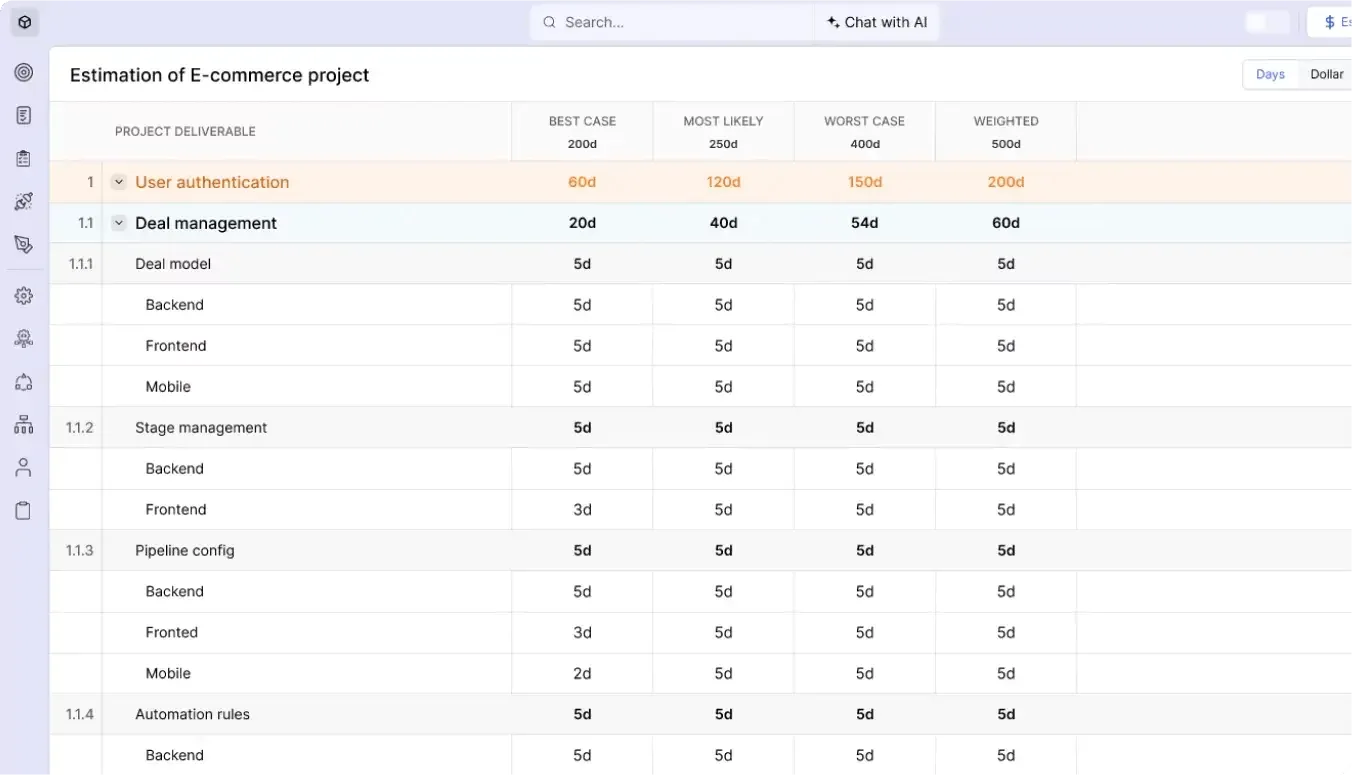

Requirement Builder- Project Estimation
DhiWise provides a systematic approach to collecting project requirements, eliminating ambiguities. This clarity allows project managers to define scope accurately, reducing estimation errors.
By analyzing feature requirements, dependencies, and complexity, DhiWise helps predict effort needed for each task. This minimizes underestimation or overestimation, leading to more precise workload distribution.
DhiWise aligns project tasks with estimated timeframes based on best practices. By automating parts of the estimation process, it helps stakeholders set realistic delivery timelines and avoid project overruns.
With structured requirement breakdowns, teams can allocate resources more effectively, ensuring optimal workload distribution and avoiding bottlenecks.
With DhiWise Requirement Builder, teams can make data-driven decisions, improve forecasting accuracy, simplify project estimation, and enhance project success rates. 🚀
Three-Point Estimation is a powerful technique that enhances project estimation accuracy by considering multiple scenarios. By using methods like Triangular Distribution and PERT, project managers can improve risk management, set realistic deadlines, and optimize resource allocation. Implementing best practices and leveraging the right tools can further enhance its effectiveness, ensuring successful project delivery
Ready to supercharge your project development process? With DhiWise Requirement Builder , your one-liner ideas transform into actionable plans faster than you can say “project deadline.” From scoping to wireframes, this tool handles the heavy lifting while you focus on innovation.
No more communication hiccups, mismanagement, and endless back-and-forths- just a centralized platform that keeps your team and clients perfectly in sync, where clarity reigns supreme and ensures you’re delivering projects faster, smarter, and with unparalleled quality.
Don’t just adapt to change—drive it. Join the revolution with DhiWise today and turn your next big idea into an actionable, client-winning masterpiece. Ready to redefine your workflow? Try DhiWise now!
